CEM I 52,5 R - Italsacci SpA - Tavernola Bergamasca
General information
| EPD Owner | Heidelberg Materials Italia |
|---|---|
| Registration number | EPD-IES-0026546:001 |
| PCR | 2019:14 Construction products (EN 15804+A2) 2.0.1 |
| c-PCR | 2019:14-c-PCR-001 Being updated - Cement and building lime (EN 16908) (c-PCR to PCR 2019:14) 1.0.0 |
| Status | Valid |
| Publication date | 2025-10-27 |
| Valid until | 2030-10-26 |
| EN 15804 compliant | Yes |
| Geographical scope | Europe |
Product images
Programme information
| Programme | International EPD System |
|---|---|
| Address | EPD International AB Box 210 60 SE-100 31 Stockholm Sweden |
| Website | www.environdec.com |
| support@environdec.com |
Product category rules
| CEN standard EN 15804 serves as the Core Product Category Rules (PCR) | |
| Product Category Rules (PCR) | PCR 2019:14 Construction products (EN 15804+A2) (2.0.1) |
|---|---|
| PCR review was conducted by | The Technical Committee of the International EPD System. See www.environdec.com for a list of members. Review chair: Rob Rouwette (chair), Noa Meron (co-chair). The review panel may be contacted via the Secretariat www.environdec.com/support. |
| Complementary Product Category Rules (c-PCR) | PCR 2019:14-c-PCR-001 Being updated - Cement and building lime (EN 16908) (c-PCR to PCR 2019:14) (1.0.0) Version: 1.0.0 |
| c-PCR review was conducted by | The Technical Committee of the International EPD System |
Verification
| LCA accountability | Giovanni Pinto, g.pinto@italcementi.it, Heidelberg Materials Italia |
|---|---|
| Independent third-party verification of the declaration and data, according to ISO 14025:2006, via | |
| EPD process certificate issued by | Certiquality Srl |
| Accredited by | Accredia |
| Accredited certification body address | Italy |
| Procedure for follow-up of data during EPD validity involves third party verifier | |
| *EPD Process Certification involves an accredited certification body certifying and periodically auditing the EPD process and conducting external and independent verification of EPDs that are regularly published. More information can be found in the General Programme Instructions on www.envrondec.com. | |
Ownership and limitation on use of EPD
Limitations
EPDs within the same product category but published in different EPD programmes, may not be comparable. For two EPDs to be comparable, they shall be based on the same PCR (including the same first-digit version number) or be based on fully aligned PCRs or versions of PCRs; cover products with identical functions, technical performances and use (e.g. identical declared/functional units); have identical scope in terms of included life-cycle stages (unless the excluded life-cycle stage is demonstrated to be insignificant); apply identical impact assessment methods (including the same version of characterisation factors); and be valid at the time of comparison.
Ownership
The EPD Owner has the sole ownership, liability, and responsibility for the EPD.
Information about EPD Owner
| EPD Owner | Heidelberg Materials Italia |
|---|---|
| Contact person name | Giovanni Pinto |
| Contact person e-mail | giovanni.pinto@heidelbergmaterials.com |
| Organisation address | Italy Peschiera Borromeo (MI) 20068 Via Lombardia, 2/A |
Description of the organisation of the EPD Owner
Since 1864, Heidelberg Materials Italia Cementi Spa has been a leader in Italy in cement production. A century-old history made of people, knowledge, and innovation has led the company to be a key player in the construction materials sector. The widespread and rooted presence in the territory and the ability to offer innovative and quality products are the basis of integrated solutions and applications capable of meeting the needs of the cement and concrete market. The industrial structure consists of 8 cement production plants, a plant for special products with a lower environmental footprint than traditional cements, and several grinding centers. The production sites have obtained ISO 14001 environmental certification, and in some geographical areas, CSC certification, which certifies the responsible sourcing process throughout the production chain, according to the basic principles of Sustainability. The industrial network is also completed and integrated thanks to the significant presence in the concrete and aggregates sector with Heidelberg Materials Italia Calcestruzzi Spa. Heidelberg Materials Italia Cementi Spa, together with Heidelberg Materials Italia Calcestruzzi Spa, offers a wide range of products, applications, and solutions, from cement to ready-mixed concrete. The category of traditional cements consists of products suitable for specific construction types: from road and marine infrastructures to civil and industrial pavements, from dams to extraction wells, to the most common use for building. Alongside traditional cements, Heidelberg Materials Italia Cementi Spa offers a range of solutions for building regeneration, with binders, natural limes, mortars, and plasters, products that offer quality, consistency, and ease of application. Moreover, there is the range of evobuild products, capable of responding to the growing market demand for solutions oriented towards environmental sustainability and the circular economy. Great importance is given to innovative solutions developed in the headquarters' laboratories, also through close collaboration with some of the most important designers and major university research centers, such as products for the regeneration and adaptation of infrastructures. Heidelberg Materials Italia Cementi Spa is a founding member of the Green Building Council Italia, the association that promotes the dissemination of circular economy principles in the construction sector, and a member of the Global Compact, the international organization that promotes the principles of sustainable development. The protection of workers' safety and health, and more generally social responsibility, are fundamental objectives for Heidelberg Materials Italia Cementi Spa and Heidelberg Materials Italia Calcestruzzi SpA. A commitment that has led to a significant improvement in results since 2000: the injury frequency index in the plants has been reduced by about 98%. Today, Heidelberg Materials Italia Cementi Spa is part of Heidelberg Materials, a global player in the sector with 53,000 employees in 3,000 production sites in 50 countries on 5 continents. Among the Group's sustainability goals is the reduction of CO2 emissions per ton of cement by 30% by 2025. Strong in its brand and industrial and cultural identity, Heidelberg Materials Italia Cementi Spa operates with its historic brand in the Italian market, with a responsible and sustainable presence in local communities.
Organisation logo
Product information
| Product name | CEM I 52,5 R Tavernola Bergamasca |
|---|---|
| Product identification | CEM I 52,5 R Tavernola Bergamasca |
| Product description | CEM I 52,5 R is a type I Portland cement with very high standardised strength and high initial strength in compliance with the UNI EN 197-1 standard. |
| Technical purpose of product | CEM I 52,5 R cement contains, in accordance with the composition prescribed by the UNI EN 197-1 standard (i.e. referring to the mass of the cement excluding calcium sulphate and additives), 95% ÷ 100% clinker, while the remaining part is made up of any secondary constituents. CEM I 52,5 R cement allows production of concretes characterized by: - Lower water demand - Excellent surface finish - Reduced risk of bleeding - Greater robustness in formulation |
| Manufacturing or service provision description | The production of the cement covered by this declaration is carried out by the Italsacci Spa - Via Riva di Solto, 24 - 24060 Tavernola Bergamasca(BG). The main technical infrastructures of the production plant consist of the reception and storage facilities for the raw materials and fuels necessary for clinker production, the main component of cement, a kiln line for clinker production, specific reception and storage facilities for other materials used in cement formulation (limestone, gypsum, granulated blast furnace slag, pozzolana, fly ash, iron sulfate, and other minor constituents), a grinding department with ball mills, storage silos for the various cements produced (some equipped with lanes for loading bulk cement), a bagging, palletizing, and loading system for bagged products. The cement plant produces clinker, an artificial mineral and the main component of cement, from limestone and clay as fundamental natural raw materials for the process. To ensure the right supply of the necessary constituents for clinker production and based on technological needs or market demands or within the framework of natural resource-saving policies, other types of natural raw materials, secondary raw materials of industrial origin, by-products, and waste can also be used. To form the clinker components, the raw materials must be finely ground and then brought to a temperature of about 1,450 °C to undergo the process called "clinkerization". The technological cycle of the cement plant can be summarized in some main phases as follows: • Phase 1: Quarry - Extraction of marl, limestone, clay, and pozzolana; • Phase 2: Crushing - Reception and storage of raw materials for the raw mix; • Phase 3: Raw Material Storage; • Phase 4: Transport - Storage deposits of materials in pieces; • Phase 5: Raw Grinding - The material is fed to the mill to be finely ground, by compression in the vertical mill, by impact in the horizontal one, to obtain a powder called flour; • Phase 6: Process Filter - Retains dust and also filters emissions from kiln; • Phase 7: Raw Flour Storage; • Phase 8: Dry Process Cooking - Double string stages; • Phase 9: Calciner - To decarbonate the flour; • Phase 10: Rotary Kiln - Clinker kiln where the material must reach 1450°C to obtain the product; • Phase 11: Cooling - With heat recovery; • Phase 12: Clinker Storage; • Phase 13: Cement Grinding - The final phase of the production process consists of grinding the clinker with gypsum and any secondary natural constituents and recovery materials. This produces cements suitable for various types of use; • Phase 14: Bagging and Transport - Bulk or 25 kg bagged cement reaches the customer and is ready for any type of use. All Heidelberg Materials Italia Cementi Spa cements are equipped with a European Conformity Certificate - CE. |
| Material properties | Volumetric mass density: 3100 kg/m3 |
| Manufacturing site | Italsacci SpA Tavernola Bergamasca (BG) Italy Tavernola Bergamasca (BG) 24060 Via Riva di Solto, 14 |
| UN CPC code | 374. Plaster, lime and cement |
| Geographical scope | Europe |
| Geographical scope description | Cement compliant to european standard reference |
Technical characteristics and performance
Technical performance
| Product name | Type category | Type category | Type category | Type category | Type category |
|---|---|---|---|---|---|
| CEM I 52.5 R | Compressive Strenght | 2 gg | >=30 MPa | 28 gg | >=52.5 MPa |
Content declaration
| Hazardous and toxic substances | The product does not contain any substances from the SVHC candidate list in concentrations exceeding 0.1% of its weight. |
|---|
| Content name | Mass, kg | Post-consumer recycled material, mass-% of product | Biogenic material, mass-% of product | Biogenic material1, kg C/declared unit |
|---|---|---|---|---|
| Limestone | 382.3 | 0 | 0 | 0 |
| Calcareous marl | 493.7 | 0 | 0 | 0 |
| Gypsum | 59.4 | 0 | 0 | 0 |
| Syntetic marl | 31.1 | 4 | 0 | 0 |
| Other secondary materials | 33.1 | 0 | 0 | 0 |
| Additives | 0.4 | 0 | 0 | |
| Total | 1000 | 4 | 0 | 0 |
| Note 1 | 1 kg biogenic carbon is equivalent to 44/12 kg of CO2 | |||
LCA information
| EPD based on declared or functional unit | Declared unit |
|---|---|
| Declared unit and reference flow | Cement: (CEM I 52,5 R Tavernola). Unit: Mass (kg). Value: 1000 Mass: 1000 kg |
| Conversion factor to mass | 1000 |
| Are infrastructure or capital goods included in any upstream, core or downstream processes? | |
| Datasources used for this EPD | ecoinvent database (general) ecoinvent 3.10 database |
| LCA Software | GCCA EPD Tool 5.2 |
| Version of the EN 15804 reference package | EF Reference Package 3.1 |
| Characterisation methods | EN 15804 reference package 3.1 |
| Technology description including background system | High mechanical resistance, in particular to short curing, makes CEM I 52.5 R ideal for use for: - prefabrication (with or without thermal cycle), especially for structures with significant static and/or architectural commitment - prestressed cast-in-place structures - structures that are not prestressed in elevation or morphologically slender - products and/or castings that require fast formwork and/or handling - works of sprayed concrete ("spritz beton") - premixed, mortars |
| Scrap (recycled material) inputs contribution level | Less than 10% of the GWP-GHG results in modules A1-A3 come from scrap inputs |
Data quality assessment
| Description of data quality assessment and reference years | The company use a pre-verified Tool for Life Cycle Assessment Cut-off rules: 1% Reference year: 2024 |
|---|
| Electricity used in the manufacturing process in A3 (A5 for services) | ||
|---|---|---|
| Type of electricity mix | Residual electricity mix on the market | |
| Energy sources | Hydro | 1.21% |
| Wind | 0.39% | |
| Solar | 7.14% | |
| Biomass | 0.75% | |
| Geothermal | 0% | |
| Waste | 6.28% | |
| Nuclear | 4.73% | |
| Natural gas | 66.51% | |
| Coal | 11.88% | |
| Oil | 1.11% | |
| Peat | 0% | |
| Other | 0% | |
| GWP-GHG intensity (kg CO2 eq./kWh) | 0.62 kg CO2 eq./kWh | |
| Method used to calculate residual electricity mix | AIB Italy Residual Electricity Mix year 2024 |
|---|
| Production stage (module A) | Excluded | |
| Use stage (module B) | Excluded | |
| End-of-Life stage (module C) | Excluded | |
| Beyond product life cycle (Module D) | Excluded |
System boundary
| Description of the system boundary | d) Cradle to gate (A1-A3). |
|---|---|
| Excluded modules | No, there is no excluded module, or there are no excluded modules |
Declared modules
| Product stage | Construction process stage | Use stage | End of life stage | Beyond product life cycle | |||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||
|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
| Raw material supply | Transport | Manufacturing | Transport to site | Construction installation | Use | Maintenance | Repair | Replacement | Refurbishment | Operational energy use | Operational water use | De-construction demolition | Transport | Waste processing | Disposal | Reuse-Recovery-Recycling-potential | |||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||
| Module | A1 | A2 | A3 | A4 | A5 | B1 | B2 | B3 | B4 | B5 | B6 | B7 | C1 | C2 | C3 | C4 | D | ||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||
| Modules declared | X | X | X | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||
| Geography | Europe | Europe | Europe | N/A | N/A | N/A | N/A | N/A | N/A | N/A | N/A | N/A | N/A | N/A | N/A | N/A | N/A | ||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||
| Share of specific data | 95.3% | - | - | - | - | - | - | - | - | - | - | - | - | - | - | ||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||
| Variation - products | 0% | - | - | - | - | - | - | - | - | - | - | - | - | - | - | ||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||
| Variation - sites | 0% | - | - | - | - | - | - | - | - | - | - | - | - | - | - | ||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||
| Disclaimer | The share of specific/primary data and both variations (products and sites) refer to GWP-GHG results only. | ||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||||

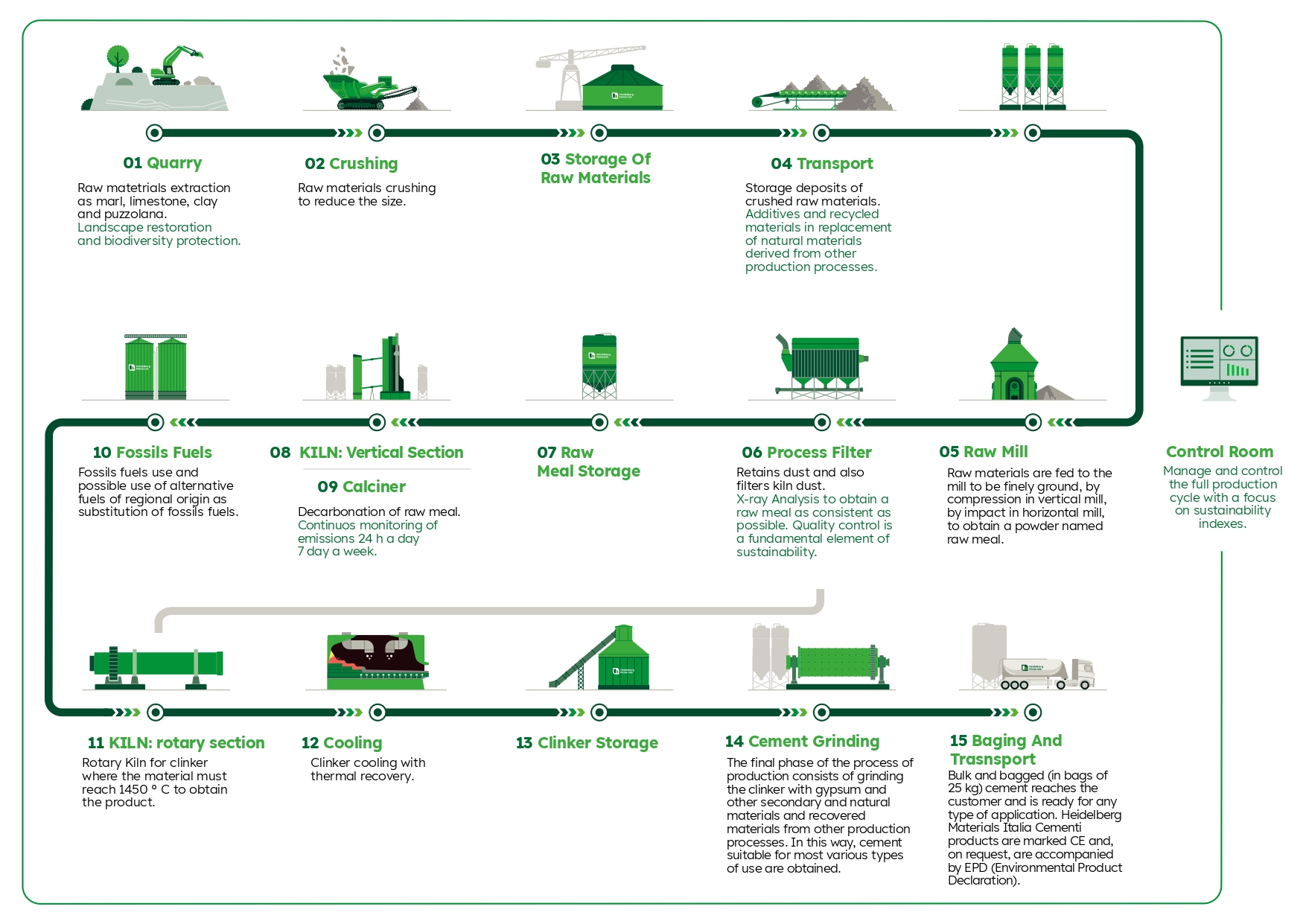

Process flow diagram(s) related images
Default scenario
| Name of the default scenario | Normal use of cement |
|---|---|
| Description of the default scenario | Normal use of cement |
Environmental performance
Mandatory environmental performance indicators according to EN 15804
| Impact category | Indicator | Unit | A1-A3 | A4 | A5 | B1 | B2 | B3 | B4 | B5 | B6 | B7 | C1 | C2 | C3 | C4 | D |
|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
| Climate change - total | GWP-total | kg CO2 eq. | 9.95E+2 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| Climate change - fossil | GWP-fossil | kg CO2 eq. | 9.91E+2 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| Climate change - biogenic | GWP-biogenic | kg CO2 eq. | 3.33E+0 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| Climate change - land use and land-use change | GWP-luluc | kg CO2 eq. | 4.41E-2 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| Ozone depletion | ODP | kg CFC-11 eq. | 6.77E-6 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| Acidification | AP | mol H+ eq. | 2.04E+0 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| Eutrophication aquatic freshwater | EP-freshwater | kg P eq. | 9.33E-3 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| Eutrophication aquatic marine | EP-marine | kg N eq. | 2.21E-1 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| Eutrophication terrestrial | EP-terrestrial | mol N eq. | 7.44E+0 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| Photochemical ozone formation | POCP | kg NMVOC eq. | 2.25E+0 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| Depletion of abiotic resources - minerals and metals | ADP-minerals&metals1 | kg Sb eq. | 2.64E-3 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| Depletion of abiotic resources - fossil fuels | ADP-fossil1 | MJ, net calorific value | 5.67E+3 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| Water use | WDP1 | m3 world eq. deprived | 4.11E+1 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| Acronyms | GWP-fossil = Global Warming Potential fossil fuels; GWP-biogenic = Global Warming Potential biogenic; GWP-luluc = Global Warming Potential land use and land use change; ODP = Depletion potential of the stratospheric ozone layer; AP = Acidification potential, Accumulated Exceedance; EP-freshwater = Eutrophication potential, fraction of nutrients reaching freshwater end compartment; EP-marine = Eutrophication potential, fraction of nutrients reaching marine end compartment; EP-terrestrial = Eutrophication potential, Accumulated Exceedance; POCP = Formation potential of tropospheric ozone; ADP-minerals&metals = Abiotic depletion potential for non-fossil resources; ADP-fossil = Abiotic depletion for fossil resources potential; WDP = Water (user) deprivation potential, deprivation-weighted water consumption | ||||||||||||||||
| Disclaimer 1 | The results of this environmental impact indicator shall be used with care as the uncertainties of these results are high or as there is limited experience with the indicator | ||||||||||||||||
Additional mandatory environmental performance indicators
| Impact category | Indicator | Unit | A1-A3 | A4 | A5 | B1 | B2 | B3 | B4 | B5 | B6 | B7 | C1 | C2 | C3 | C4 | D |
|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
| Climate change - GWP-GHG | GWP-GHG1 | kg CO2 eq. | 9.95E+2 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| Acronyms | GWP-GHG = Global warming potential greenhouse gas. | ||||||||||||||||
| Disclaimer 1 | The GWP-GHG indicator is termed GWP-IOBC/GHG in the ILCD+EPD+ data format. The indicator accounts for all greenhouse gases except biogenic carbon dioxide uptake and emissions and biogenic carbon stored in the product. As such, the indicator is identical to GWP-total except that the CF for biogenic CO2 is set to zero. | ||||||||||||||||
Resource use indicators according to EN 15804
| Indicator | Unit | A1-A3 | A4 | A5 | B1 | B2 | B3 | B4 | B5 | B6 | B7 | C1 | C2 | C3 | C4 | D |
|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
| PERE | MJ, net calorific value | 1.11E+2 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| PERM | MJ, net calorific value | 0.00E+0 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| PERT | MJ, net calorific value | 1.11E+2 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| PENRE | MJ, net calorific value | 5.67E+3 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| PENRM | MJ, net calorific value | 0.00E+0 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| PENRT | MJ, net calorific value | 5.67E+3 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| SM | kg | 1.01E+2 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| RSF | MJ, net calorific value | 0.00E+0 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| NRSF | MJ, net calorific value | 0.00E+0 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| FW | m3 | 1.01E+0 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| Acronyms | PERE = Use of renewable primary energy excluding renewable primary energy resources used as raw materials; PERM = Use of renewable primary energy resources used as raw materials; PERT = Total use of renewable primary energy resources; PENRE = Use of non-renewable primary energy excluding non-renewable primary energy resources used as raw materials; PENRM = Use of non-renewable primary energy resources used as raw materials; PENRT = Total use of non-renewable primary energy re-sources; SM = Use of secondary material; RSF = Use of renewable secondary fuels; NRSF = Use of non-renewable secondary fuels; FW = Use of net fresh water. | |||||||||||||||
Waste indicators according to EN 15804
| Indicator | Unit | A1-A3 | A4 | A5 | B1 | B2 | B3 | B4 | B5 | B6 | B7 | C1 | C2 | C3 | C4 | D |
|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
| HWD | kg | 2.64E+0 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| NHWD | kg | 2.00E+0 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| RWD | kg | 2.11E-3 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| Acronyms | HWD = Hazardous waste disposed; NHWD = Non-hazardous waste disposed; RWD = Radioactive waste disposed. | |||||||||||||||
Output flow indicators according to EN 15804
| Indicator | Unit | A1-A3 | A4 | A5 | B1 | B2 | B3 | B4 | B5 | B6 | B7 | C1 | C2 | C3 | C4 | D |
|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|---|
| CRU | kg | 0.00E+0 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| MFR | kg | 0.00E+0 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| MER | kg | 0.00E+0 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| EEE | MJ, net calorific value | 0.00E+0 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| EET | MJ, net calorific value | 0.00E+0 | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND | ND |
| Acronyms | CRU = Components for re-use; MFR = Materials for recycling; MER = Materials for energy recovery; EEE = Exported electrical energy; EET = Exported thermal energy. | |||||||||||||||
Additional environmental information
The recycled material content of the product covered by this declaration has been determined in accordance with ISO 14021:2016.
Content of recycled material by mass (Year 2024)
- Pre-consumer recycled material (%): 5.1
- Post-consumer recycled material (%): 4.0
- Total recycled material (%): 9.1
Additional social and economic information
Tavernola Bergamasca (BG) plant of Italsacci SpA is certified according to ISO 14001:2015 and ISO 9001:2015, in line with the Policies and strategies of Heidelberg Materials Italia Cementi Spa and Heidelberg Materials.
Abbreviations
Not relevant
References
- ISO 14021:2016 Environmental labels and declarations - Type II environmental declarations
- ISO 14025:2010 Environmental labels and declarations - Type III environmental declarations
- ISO 14040:2006 Environmental management - Life cycle assessment - Principles and Framework
- ISO 14044:2006 Environmental management - Life cycle assessment - Requirements and Guidelines
- EN 15804:2012+A2:2019/AC:2021 Sustainability of construction works - Environmental product declarations - Core rules for the product category of construction products
- EN 16908:2017+A1:2020 Sustainability of construction works - Environmental product declarations
- PCR 2019:14 Construction products (EN 15804+A2) v. 2.0.1
- C-PCR-001 ”Cement and building lime” (EN 16908) to PCR 2019:14 v. 1.0.0
- GPI General Programme Instructions of IES www.environdec.com (Version 5.0)
Version history
First version
